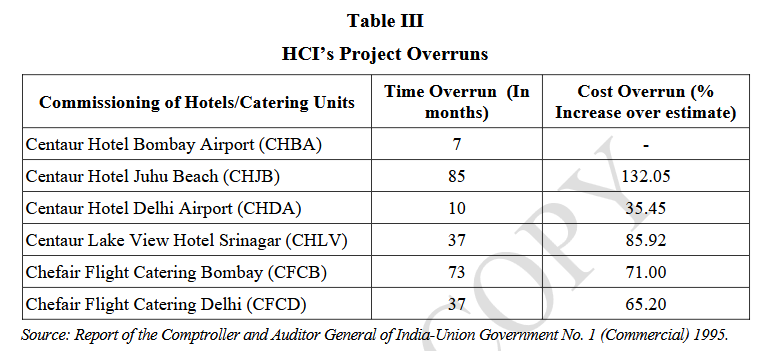

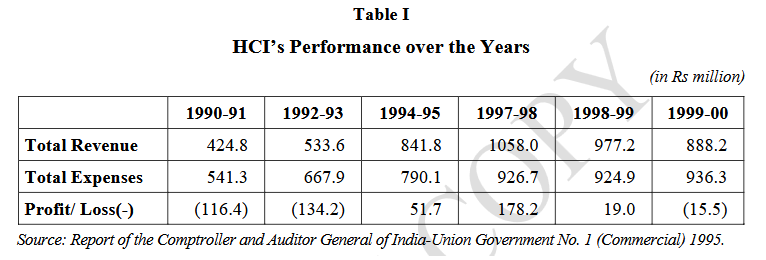

Analysts attributed a majority of HCI?s problems to poor planning. Most of the company's hotel projects ran into huge cost and time overruns, because of faulty planning and implementation. Between 1975-1986, projects worth Rs 527.6 million were completed at a total cost of Rs 881.9 million (Refer Table III).

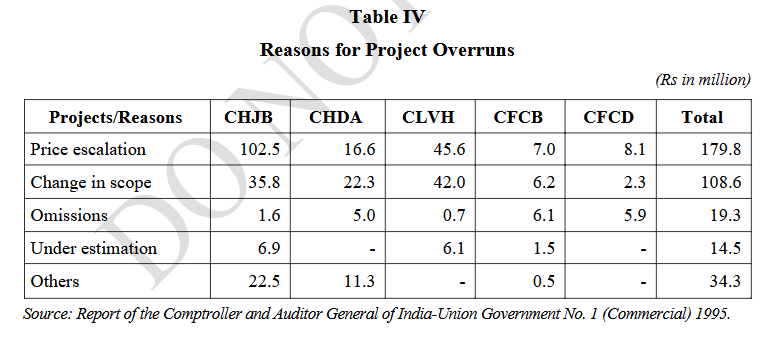

While a major part of the increase in the cost of the projects was primarily due to price escalation arising from time overruns, there was also a sizeable increase in the costs on account of changes in the scope of the project, indicating a lack of proper planning (Refer Table IV).
In many cases, HCI's resources had been mismanaged. Some of them are as follows:
* HCI had begun the construction of the CHJB in 1980, without getting the plans approved from the Bombay Metropolitan Regional Development Authority (BMRDA) and the Municipal Corporation of Greater Bombay. Later, the authorities made changes in the plans and HCI had to alter its construction plans. HCI got final clearances in June 1982. However, the implementation of the project was delayed due to revision of related drawings, designs, etc. Due to the design revisions, the consultants demanded a higher fee. This demand had to be acceded to, as any change in consultants at this stage would have delayed the project further. In spite of this increase in fees, the consultants failed to deliver the required drawings in time. This delay resulted in the contractors for air conditioning and electrical works claiming higher fees as well.
* HCI faced similar problems with its contractors and architects during the construction of CHLV. The contractors who had completed the structural work of the hotel asked for more money and pleaded their inability to proceed further, citing the lack of adequate resources. There were even reports of contractors stealing a huge amount of material belonging to HCI. In most of these cases, HCI had to deal with prolonged litigation or had to settle for damages awarded through arbitration.
* The CHLV had imported laundry equipment in December 1983 at a cost of Rs 7.2 million. After May 1985, due to poor occupancy, low voltage power supply and the absence of trained staff, the equipment was used only to a limited extent. While on one hand the laundry equipment was not fully utilized, on the other hand, between April 1984 and November 1986, the laundry services were entrusted to a private firm at Srinagar, involving an expenditure of Rs 0.37 million. During the period 1984-85 to 1987-88 the revenue earned by the hotel from laundry services was a mere Rs 0.63 million. The interest charges alone for these four years on the investment (at 18% per annum) amounted to Rs 5.2 million. The equipment was then transferred to CHJB in July 1991. However, the equipment could be installed only partly at CHJB, as some parts of the machine could not be transported to Bombay due to reasons stated
to be beyond HCI's control.
* HCI had begun the construction of CHDA on land belonging to the International Airport Authority of India, without getting the building plans approved by the Municipal Corporation of Delhi (MCD). Following this, the MCD imposed a penalty of Rs 3.12 million on HCI. This was reduced later to a token penalty of Rs 0.31 million, after extensive deliberations, and at the instance of the Ministry of Tourism and Civil Aviation.
* HCI contracted for supply of 4161 kW of electricity from Delhi Electricity Supply
Undertaking (DESU), effective from September 1982, for CHDA. The contracted load was based on the requirements originally planned, which also included electricity requirements for laundry equipment and for a discotheque. However, as the laundry and the discotheque were not constructed, the actual usage of power was less than the contracted demand. HCI thus approached DESU in February 1984 for reducing the contracted demand to 2100 kW. However, DESU did not agree to this, as according to the agreement between HCI and DESU, the demand level could not be altered till 1987. But even after 1987, the company did not approach DESU to have the contracted demand reduced. Consequently, the minimum billing, which was 60% of the contracted demand and which was higher than recorded consumption every month, was paid by HCI, resulting in avoidable expenditure of Rs 5.4 million during
1982-90.
* In September 1986, HCI procured 23 cold storage units at a total cost of Rs 3.6 million and installed them at CFCB. The units were not operated during the first year. Only five cold storage units were in use, two had been given on hire to ITDC, three were kept as standby, and the remaining were kept idle. Thus, the investment of Rs 2.81 million in the 13 remaining cold storage units not put in operation was lying unused. The company justified the buying of extra units by citing faulty capacity utilization estimates.

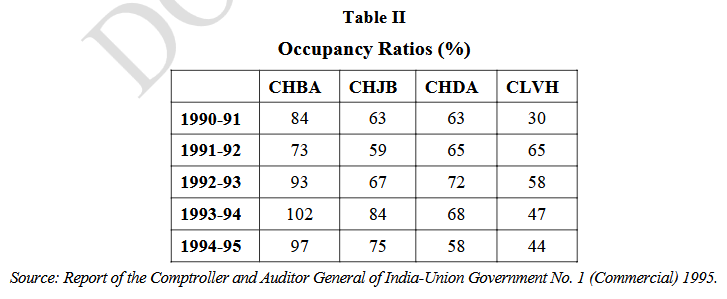

AI's flights from Bombay were catered exclusively by HCI?s flight kitchens till June 1981. However, the upliftment of meals came down to as low as 21.72% in 1994-95. This resulted in poor capacity utilization at the units and both of the flight kitchen units ran into huge losses. In spite of this, the units went in for a major expansion of their operations. Meal upliftment by AI meanwhile declined further as the airline found the meals served by HCI to be of poor quality, not upto international standards and not competitively priced. High staff costs at the flight kitchens further compounded their problems.

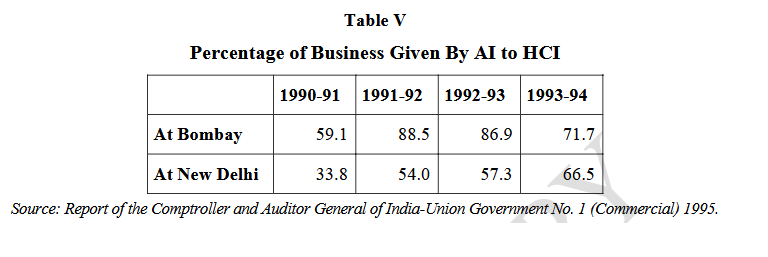

Even though HCI was AI's wholly owned subsidiary, the business given by AI to HCI's hotels in Delhi ranged from only 34-66% and in Bombay from 59-88% (Refer Table V). Also, room tariff offered by AI to HCI was quite low compared to the rest of the hotel industry. Even after new rates were set (following HCI?s request to AI to revise the room tariff) for AI passengers, crew and officials in October 1992, the charges were only 45% of the normal HCI tariff. Similarly, after the rate increase in October 1994, the fares were just 42% of the normal tariff.
With the government's decision to disinvest its stake in AI, HCI was also put up for sale. The government invited bids for individual HCI properties as well as the entire company. Indian Hotels, the Oberoi group and the ITC group were reported to be interested. As the government had allowed foreign hotel chains to bid for HCI properties through the 51% automatic approval route from the Foreign Investment Promotion Board (FIPB), a number of international hotel chains also showed interest in HCI. These included the Carlson Group, Bass Hotels, and the Rassel Group from Singapore, among others. By November 2000, the government claimed to have received a very good response to the HCI sale. A total of 37 parties showed interest in bidding for HCI, of which 28 were shortlisted. Of these, 13 were selected for putting in the financial bids. At this point, the Ministry of Civil Aviation and the Disinvestment Commission decided to keep the foreign investors away from the HCI sale.
There were no further significant developments in the sale of HCI till May 2001, when the government announced that the HCI disinvestment completion deadline had been postponed to the third week of June. Attributing this delay to certain unavoidable 'procedural problems,' a government official said, βThe government is keen on doing a good job, rather than rush through with the process and face the music later.β In June 2001, the government announced that it would soon be inviting financial bids for HCI after completing the legal documentation.
